About this template

One page that has to survive budget and safety review

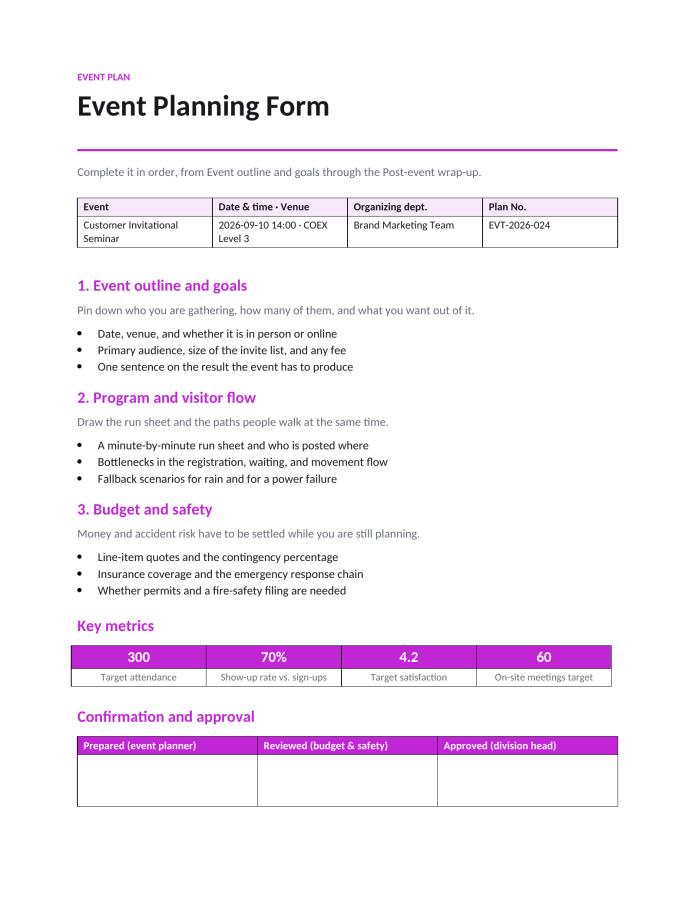

An event plan is read by two people who do not care about the theme: whoever signs the budget, and whoever is responsible if something goes wrong. This form is built around that. The label above the title reads Event plan, the gray line under the title reads “Complete it in order, from Event outline and goals through the Post-event wrap-up”, and the approval row ships as Prepared (event planner), Reviewed (budget & safety), Approved (division head). The page runs label, title, gray lead, a four-cell information table, three numbered sections, Key metrics, and Confirmation and approval.

Filling order

  1. Fill the four information cells: Event, Date & time · Venue, Organizing dept. and Plan No. They ship as Customer Invitational Seminar, 2026-09-10 14:00 · COEX Level 3, Brand Marketing Team and EVT-2026-024.
  2. 1. Event outline and goals first, and stop when it is done. Nothing below can be judged until the audience, the size and the intended result are fixed.
  3. 2. Program and visitor flow next – the run sheet and the paths people walk, drawn together rather than one after the other.
  4. 3. Budget and safety last, because both are priced off the program.
  5. Fill the Key metrics table and print the approval row empty.

How the three sections read

  • Event outline and goals. Date, venue, and whether it is in person or online; the primary audience, the size of the invite list, and any fee; and “One sentence on the result the event has to produce”. That single sentence is what the wrap-up will be measured against, so avoid anything that cannot be judged the day after.
  • Program and visitor flow. A minute-by-minute run sheet with who is posted where, the bottlenecks in the registration, waiting and movement flow, and fallback scenarios for rain and for a power failure. The bottleneck line is the one planners skip; a seminar that runs perfectly on paper still fails at a single registration desk.
  • Budget and safety. Line-item quotes and the contingency percentage, insurance coverage and the emergency response chain, and whether permits and a fire-safety filing are needed. Check the permit question against the venue’s own requirements early – it is the item with the longest lead time and the one that can cancel an event outright.

The four metric cells

Key metrics is a two-row, four-column table with values on top: 300 / Target attendance, 70% / Show-up rate vs. sign-ups, 4.2 / Target satisfaction, 60 / On-site meetings target. The first two work as a pair – 300 attending at a 70% show-up rate means roughly 430 sign-ups, so the registration target follows from these cells rather than being set separately. Word does no arithmetic, so if you change the attendance target, change the sign-up assumption in section 1 by hand. Satisfaction and on-site meetings are the two the wrap-up will report against, so define now how each will be measured.

Turning the plan into the wrap-up

The gray lead promises sections through to the post-event wrap-up, and the shortest way to get there is to keep this file and add to it rather than starting a new document. After the event, put the actual numbers beside the four targets, note where the run sheet slipped and by how many minutes, and record what the contingency was actually spent on. The next planner reads the gap between plan and actual, not the plan. Attachments follow the same logic: the budget, the run sheet, the venue contract, the safety plan, the artwork and the attendee list all belong with the plan rather than in a separate folder.

Before it goes for approval

  • A goal such as raising awareness, which cannot be judged the day after the event.
  • A budget with no contingency line. Reviewers read its absence as an incomplete estimate.
  • Naming a venue before checking whether it needs a permit or a fire-safety filing.
  • Leaving the sample date, venue and plan number in place while the program is already your own.
  • Writing a run sheet with no name against each slot, which leaves nobody responsible on the day.
