About this template
When to use it
A three-page services agreement signed by the client (Party A) and the contractor (Party B). Articles 1 to 15 are already drafted, so the job is replacing figures and proper nouns and striking what you do not need.
Filling order

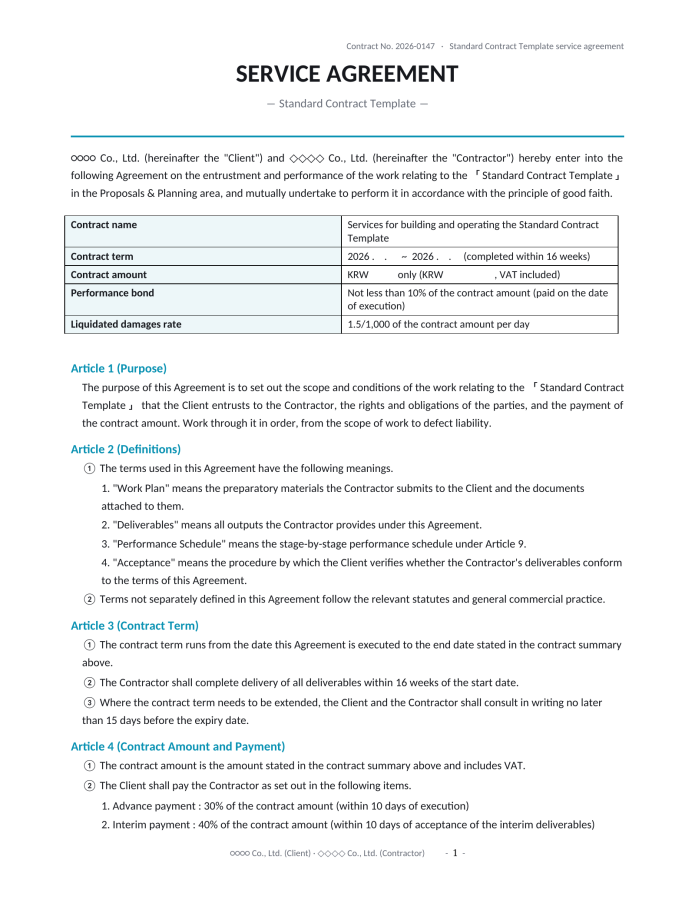

- Replace the placeholder company names in the preamble. The same names sit in the footer and the header carries reference No. 2026-0147, so edit those too.
- Complete the five-row summary table: title, term, amount including VAT, performance bond, damages rate. Articles 3, 4 and 13 refer back to it, so changing the table alone leaves the contract contradicting itself.
- Check Article 4: 30% advance, 40% interim, 30% balance, each with its own deadline, plus 6% annual interest on late payment.

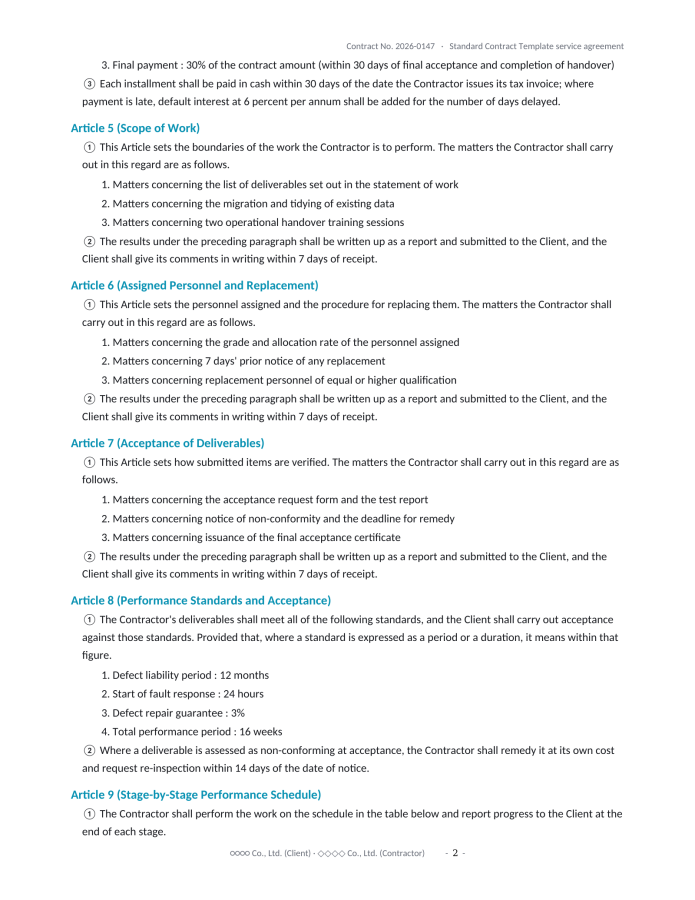

- Articles 5 to 7 are the scope clauses; replace items 1 to 3 under paragraph (1) of each with your deliverable areas.
- Article 8 lists four acceptance criteria – a 12-month defect liability period, incident response starting within 24 hours, a maintenance bond of 3/100, and a 16-week total delivery period. Paragraph (1) reads them as ceilings. Swap in values you can measure.

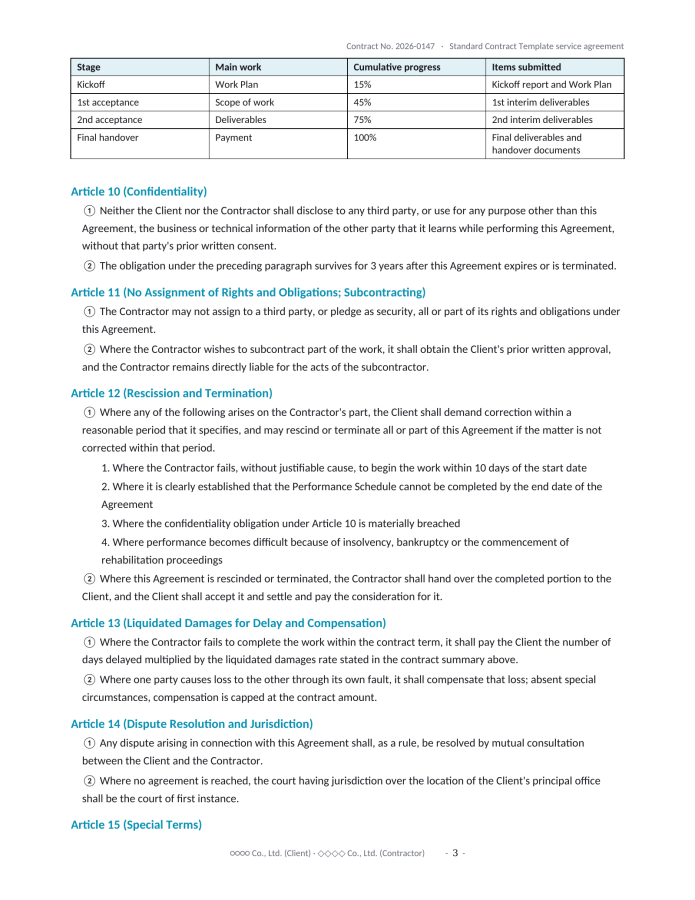

- Align the Article 9 schedule table (kick-off, first inspection, second inspection, final acceptance, with cumulative progress of 15, 45, 75 and 100%) with your actual phases.

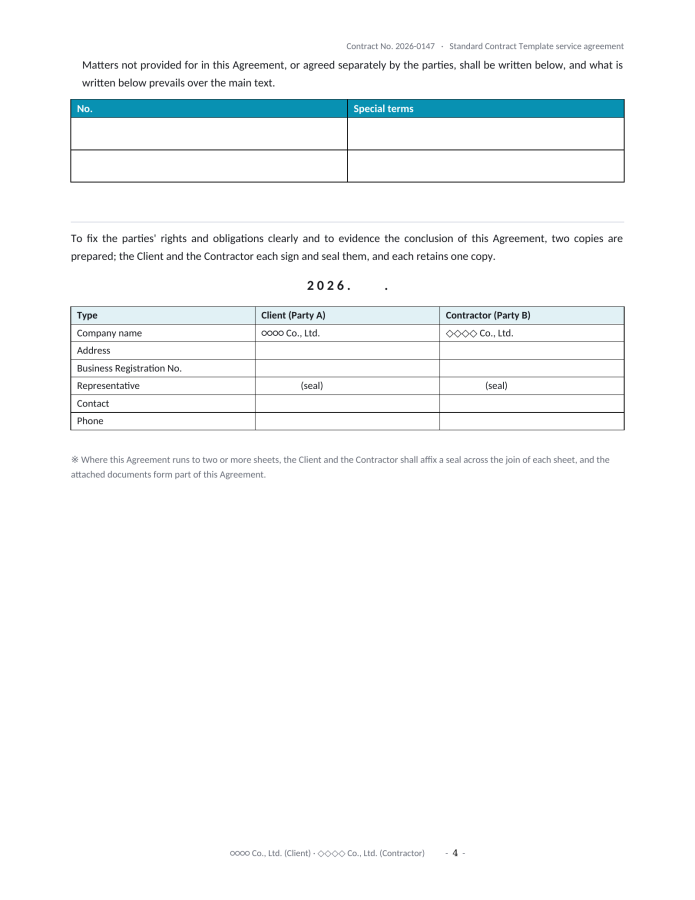

- Record side agreements in the two-row special-terms table under Article 15, then complete the signature block for both parties and seal the representative row.
How the figures are calculated
- Liquidated damages = contract amount x 1.5/1000 x days late. On KRW 60,000,000, ten days late costs KRW 900,000.
- The performance bond is at least one tenth of the amount – KRW 6,000,000 here – payable on signing.
- Interim payment falls due within 10 days of interim acceptance, the balance within 30 days of final acceptance and handover; past 30 days from the tax invoice date, 6% annual interest accrues.
Common mistakes
- Changing the duration in one place only. The 16 weeks appears in the summary table, Article 3(2) and Article 8 item 4.
- Party B signing without reading Article 14, which fixes jurisdiction at Party A’s principal office – a negotiable point.
- Just stapling the three pages; the closing note requires a seal across the join once the contract runs to two or more sheets.
