Timesheet Template
Specifications
- Sheets
- 3 sheets
- File format
- Excel (.xlsx)
- Font
- Calibri
- Version
- 1.0
- Editing
- Fully editable
- Primary color
-
#0369A1
Style
Tags
The previews are printed pages. The file has 3 sheets.
About this template
When to use it

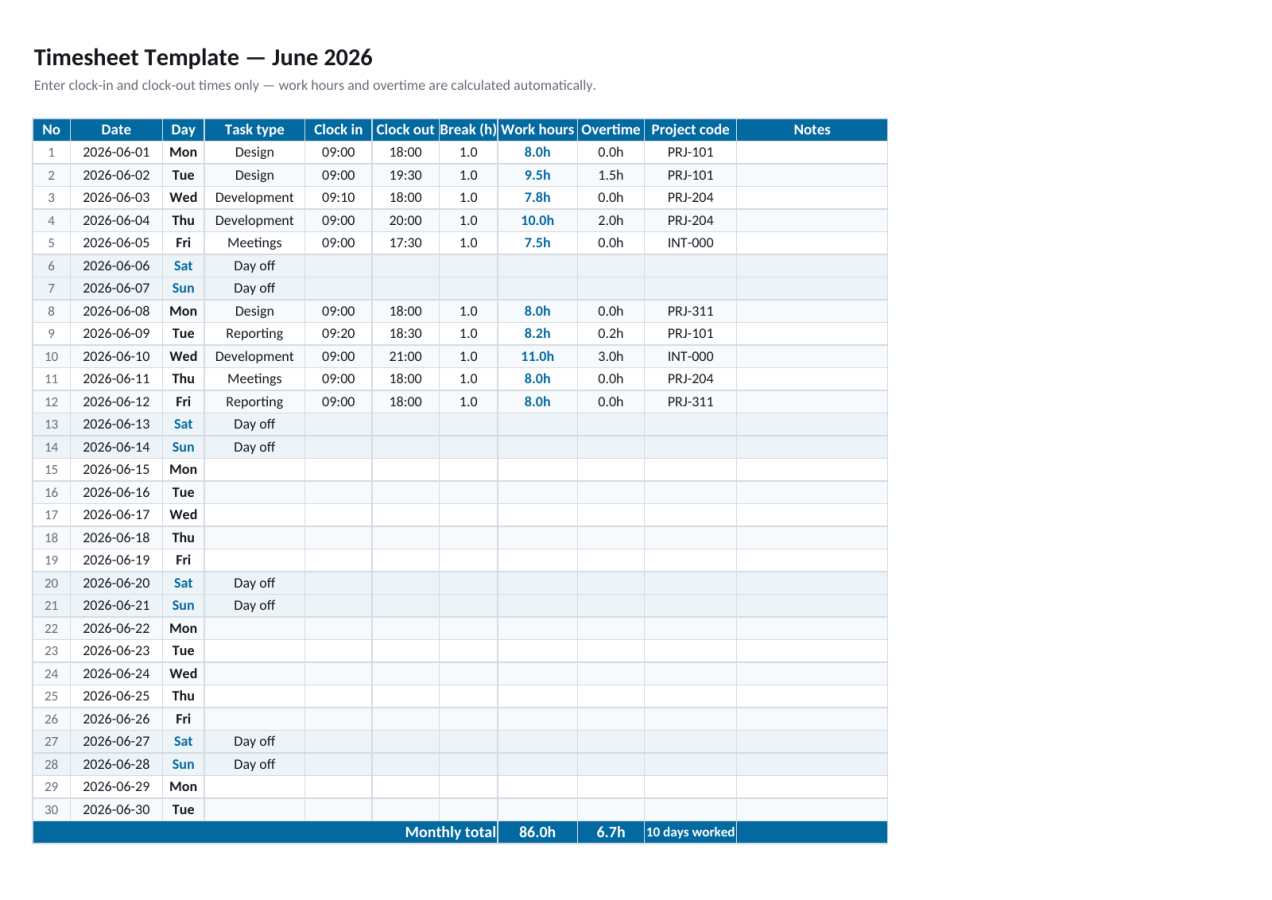

A month of work for anyone who must allocate hours to projects. Three sheets — Work log, Weekly & monthly summary, How to fill in — with the first titled “Timesheet Template — June 2026”. Enter clock in, clock out and break; work hours and overtime calculate themselves.
Filling order
- Rows 6–35 are 1–30 June; column D fills its weekday from =IF(C6=””,””,CHOOSE(WEEKDAY(C6,2),”Mon”,”Tue”,”Wed”,”Thu”,”Fri”,”Sat”,”Sun”)) — Monday through Sunday.
- Column E takes one of four exact strings — Design, Development, Meetings, Reporting — because the summary sheet groups them with SUMIF. Days off are marked Day off, which no SUMIF picks up.
- Enter clock in (F), clock out (G) and break in hours (H). Columns I and J are formulas.
- Column K holds the project code that justifies billing; internal work is coded INT-000, per rule 4.
- The only cell for you on the summary sheet is the 160-hour monthly standard (C15).
How the formulas calculate
- Work hours =IF(OR(F6=””,G6=””),””,ROUND((G6-F6)*24-N(H6),1)); overtime =IF(I6=””,””,ROUND(MAX(0,I6-8),1)), counting only what passes eight hours a day.
- Row 36 totals with =SUM(I6:I35), =SUM(J6:J35) and =COUNT(I6:I35)&” days worked”, which prints as “N days worked”.

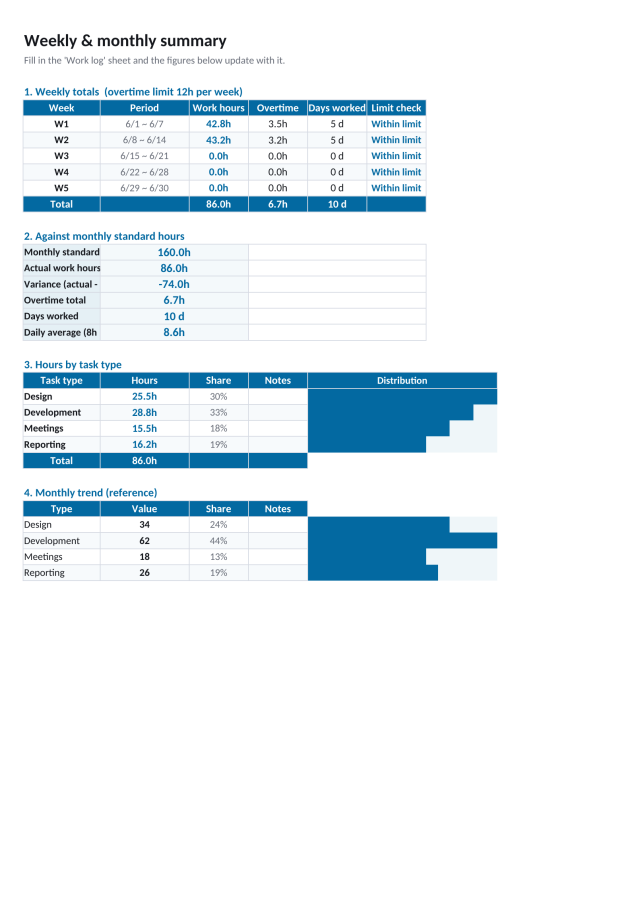

- Weekly rows use =SUM(‘Work log’!I6:I12), and the limit check is =IF(E7>12,”Over limit”,”Within limit”) against the 12-hour weekly overtime cap in the rules.
- Hours by task type is =SUMIF(‘Work log’!$E$6:$E$35,”Design”,’Work log’!$I$6:$I$35) — the wording is baked in, so rename a task type in B24:B27 and in the formula together.
- The daily average is =IFERROR(C16/C19,0) and the variance =C16-C15 against the monthly standard.

Know this first
Rule 1 on the How to fill in sheet says “work hours (column H) and overtime (column I)”, but work hours are in column I and overtime in column J; H is the break. Table 4 on the summary sheet is titled “Monthly trend (reference)” yet its rows are Design, Development, Meetings, Reporting (34, 62, 18, 26) — task types, not months, and hand-typed, so this month’s entries never move them. Retitle it or replace it with real monthly totals. Nothing aggregates the project code; for hours per project add =SUMIF(‘Work log’!$K$6:$K$35,”PRJ-101″,’Work log’!$I$6:$I$35) yourself.
Examples
- 2 June · Design · 09:00 · 19:30 · break 1 · PRJ-101 → 9.5 hours, 1.5 overtime.
- 10 June · Development · 09:00 · 21:00 · break 1 · INT-000 → 11.0 hours, 3.0 overtime.
- Once a week’s overtime passes 12 hours, that week’s check cell reads “Over limit”.
Common mistakes
- Inventing task type names such as “Development 2”, which SUMIF then ignores.
- Writing “1 hour” instead of the number 1 in the break column.
- Submitting with the project code blank, leaving no basis for billing.
- Reusing the file for a 31-day month without extending row 36 and the weekly ranges.
